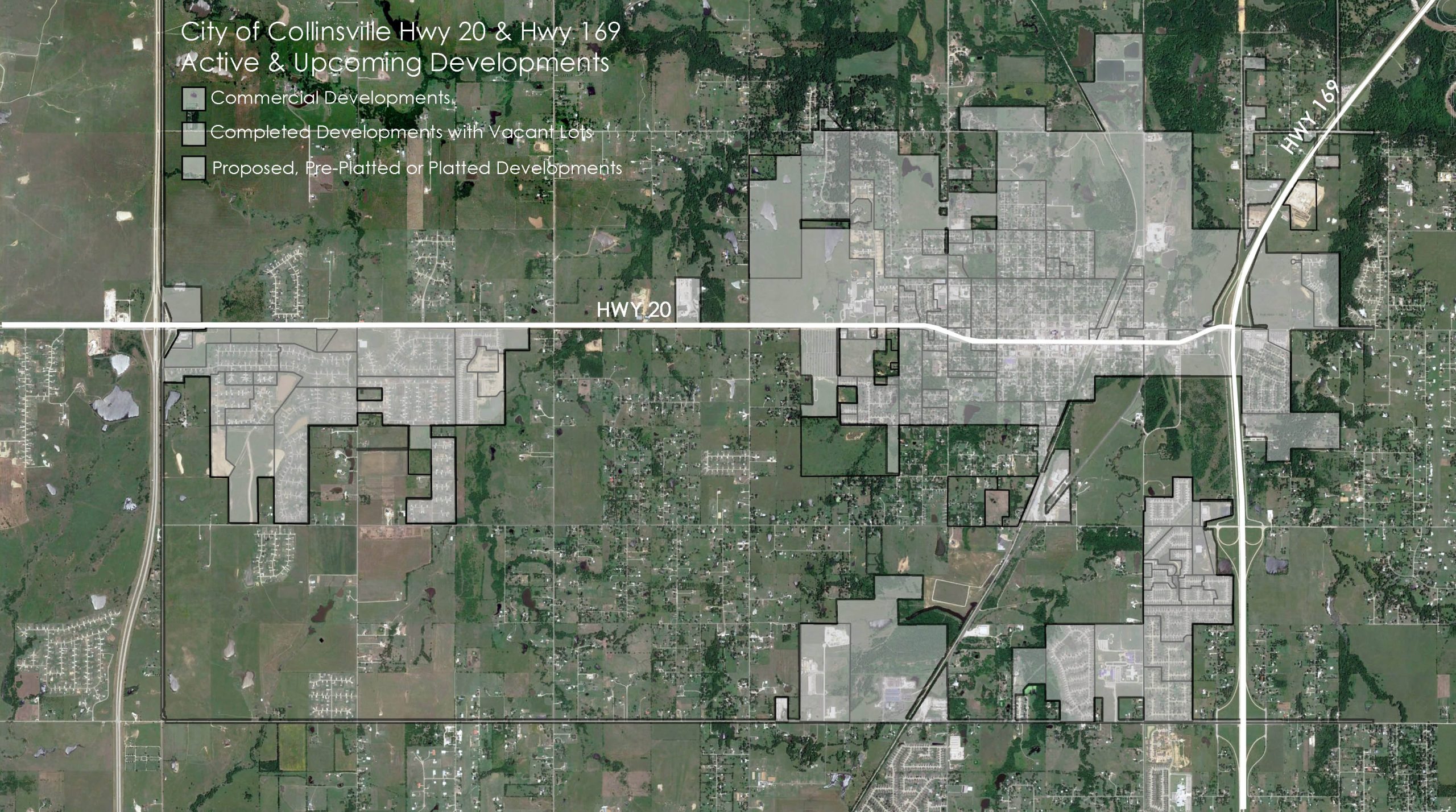

Commencial Developments
Commercial Development
Current Commercial Developments include Sonic & Arby's at 7520, with 5 vacant lots ready to build, and potentially 10 vacant lots at the Shoppes at Cooper Crossing.
Active Developments: 26 houses under construction, with 80 vacant lots
There are potentially 899 lots available in these developments, or which 139 vacant lots ready to be built on by home builders.
Cooper Ranch 1
This is a Commercial Development for 10 lots, ranging from over 1/2 acres to 1 3/4 acre lots.
Current Status: Pre-platted
Projected completion: 2026
Cooper Crossing Extended IV
Development for 21 Residential lots.
Current Status: Complete with lots ready for building permits.
Estimated to be fully built out by 2025.
Hollow Creek Extended IV
Development for 63 Residential Lots
Status: Pre-platted, Final Plat &
Completion of infrastructure expected by 2028
& to be fully built out by 2030.
Cooper Crossing Extended III
Residential Addition for 38 homes. (31) occupied,
(0) Under construction, (7) vacant lots.
Expected to be fully built out 2024
4 - Bar Ranch
Residential Addition for 111 homes. 104 completed,
1 under construction with 6 vacant lots.
Expected to be fully built out 2024.
Cherokee Hills
Development for 16 Residential Lots
Status: Pre-platted, Final Plat &
completion of infrastructure expected by 2026
& to be fully built out by 2028
Meadow at Rock Creek
Residential Addition for 57 homes. 50 complete with 7 vacant lots,
expected to be fully built out 2024
Cherry Creek IV
Residential Addition for 43 homes. 17 complete,
5 under construction, with 21 vacant lots.
Expected to be fully built out 2024.
Cherry Creek III
Residential Addition for 55 homes. 14 complete,
18 under construction, with 23 vacant lots.
Expected to be fully built out by 2024
Hidden Lake
Development for 339 Residential Lots
Status: Pre-platted, Final Plat expected & completion of infrastructure expected by 2028 is it goes ahead,
& would then be built out by 2031.
The Estates at Edgewood
Residential Addition for 62 Lots. 45 complete,
1 under construction with 16 vacant lots.
Expected to be fully built out 2024
Georgetowne
Development for 118 Residential lots.
Current Status: Complete with lots ready for building permits.
Estimated to be fully built out by 2025.
Stonegate Extended IV
Development for 12 Residential Lots
Status: Pre-platted, Final Plat & completion of infrastructure expected 2025
& to be fully built out by 2027.
Hidden Hills
Development for 50 Residential Lots
Status: The infrastructure is under construction & is expected to be complete and platted by 2026, & fully built out by 2028.
Collinsville Industrial Park Re-Plat
Industrial Development for 11 lots.
6 occupied with 5 vacant lots.
Dogwood Villa
Development for 21 Residential Lots
Status: Pre-platted, Final Plat & completion of infrastructure expected 2026,
& to be fully built out by 2028.
Eddie James Development
This is a 58 acre commercial development.
Current status: Property annexed into City Limits, & if it starts the the pre plat process could be complete by 2028.
Judy Turner Property
This is a 155 acre commercial development.
Current Status: This will be annexed into City Limits by Feb 2024, & is expected to be developed quickly, by 2026.
7520
This is a commercial development with 7 lots.
Current status: Development Complete with Sonic & Arbys under construction, with 5 vacant lots.
Estimated completion of full build out: 2025
Colpitt Crossing
Development for 259 Residential Lots
Status: Pre-platted, Final Plat &
Completion of infrastructure expected by 2025
& to be fully built out by 2027.
